Enterprise Microsoft Fabric Migration: A Platform-by-Platform Guide
Introduction
Microsoft Fabric has become the target destination for enterprise data platform modernization. The economics are compelling: a single, unified analytics platform that consolidates compute, storage, pipelines, and reporting under one licensing model. Organizations running legacy data warehouses on Synapse, Teradata, Oracle, and SQL Server are all evaluating Fabric as the next-generation platform.
The challenge is that "migrating to Fabric" means something completely different depending on where you are starting. A Synapse Dedicated SQL Pool migration and an Oracle data warehouse migration share the same destination but almost nothing else. The SQL dialect gap, the volume of code conversion, the architecture redesign, and the ecosystem rebuild vary dramatically by source platform. Understanding these differences is the first step toward a realistic Microsoft Fabric migration plan.
Why Source Platform Matters More Than Destination Features

Most Fabric migration planning starts with the destination: What can Fabric do? What are its features? How does the licensing work? This is the wrong starting point. The migration timeline, cost, and risk are determined almost entirely by what you are migrating from, not what you are migrating to.
A SQL Server estate with 85% T-SQL compatibility is a fundamentally different migration than an Oracle estate where every PL/SQL package needs a complete rewrite. A Synapse Dedicated SQL Pool with distribution logic baked into every table is different from a Teradata system with thousands of BTEQ scripts. The destination is the same, but the path to get there varies from months to years depending on the source.
Teams that plan a generic "Fabric migration" without accounting for source-specific complexity consistently underestimate timelines by 40 to 60%. The estimation error is not in the Fabric implementation. It is in the conversion, rewriting, and rebuilding of the source platform’s unique constructs.

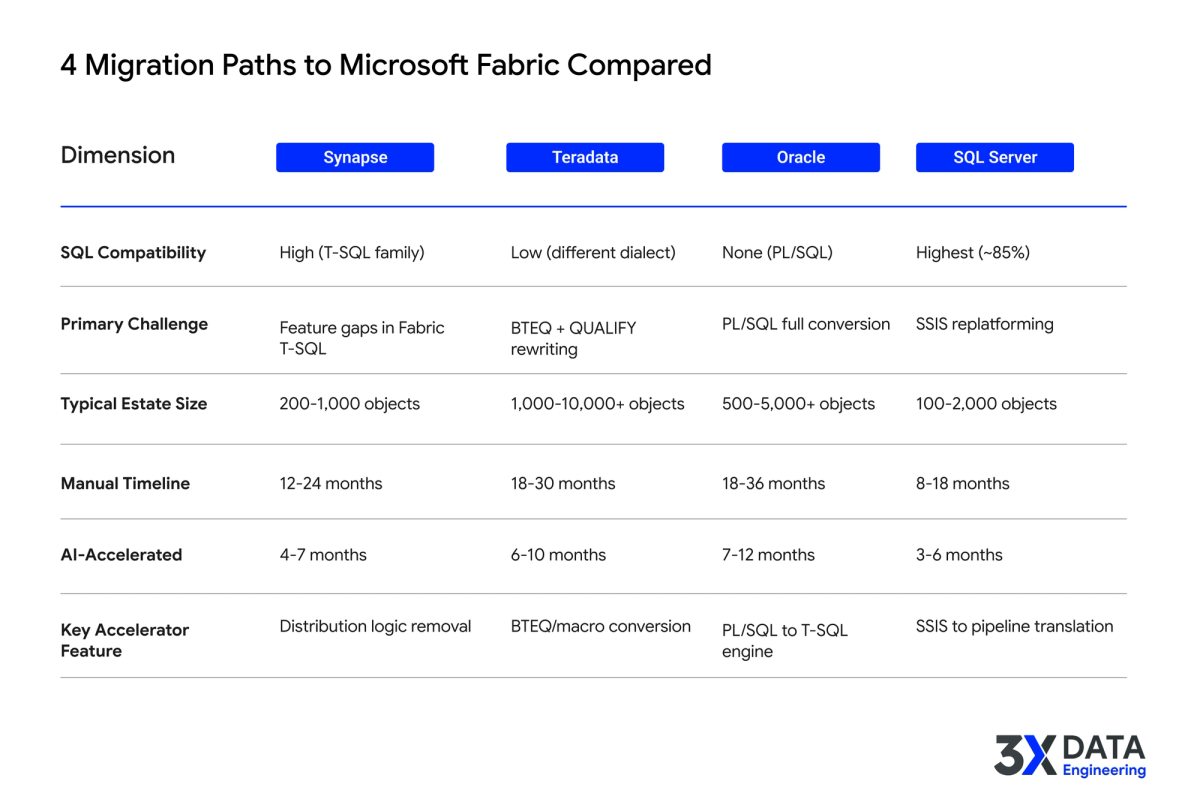

Synapse to Fabric: From 12-24 Months to 4-7 Months
For a deep dive into Synapse-specific challenges, see our guide on compressing a 12-24 month manual Synapse migration into a 4-7 month AI-accelerated program.
Synapse Dedicated SQL Pool to Fabric
Synapse to Fabric is the most natural Microsoft Fabric migration path because both platforms live in the Microsoft ecosystem and share a T-SQL foundation. But “natural” does not mean “simple.” Fabric Warehouse behaves more like Synapse Serverless than Dedicated Pool, which means features your team relies on, like hash and replicated table distribution, external tables, and multi-statement table-valued functions, do not carry over directly.
The biggest technical challenge is the distribution logic redesign. Every CREATE TABLE statement with a distribution clause needs to be rewritten for Fabric’s automatic MPP engine. Performance tuning assumptions built around distribution keys no longer apply. The architecture decision between Fabric Warehouse and Lakehouse (most enterprises use both in a hybrid medallion pattern) adds another layer of complexity that pure T-SQL migration does not address.
Typical timeline: 12 to 24 months manual, 4 to 7 months AI-accelerated.
Teradata to Fabric
Teradata to Fabric is the most labor-intensive migration path. Teradata SQL and Fabric T-SQL share almost no syntax. BTEQ scripts, the command-line scripting tool deeply embedded in most Teradata estates, contain procedural .IF/.GOTO logic, ERRORCODE handling, and session management that have no Fabric equivalent. Every BTEQ script needs to be analyzed for intent and rebuilt from scratch.
Beyond BTEQ, Teradata’s QUALIFY clause (used in 30 to 40% of stored procedures) needs CTE-based rewrites. FastLoad, MultiLoad, and TPump utilities need complete reimplementation. The PE/AMP architecture is fundamentally different from Fabric’s OneLake model. And Teradata estates tend to be the largest and most mature, often containing 10,000+ objects with decades of accumulated business logic and tribal knowledge.
Typical timeline: 18 to 30 months manual, 6 to 10 months AI-accelerated.
Oracle to Fabric
Oracle to Fabric requires the most extensive code rewrite of any migration path. PL/SQL and T-SQL are different languages with different programming paradigms. Oracle packages, the primary organizational unit for PL/SQL code, bundle procedures, functions, types, and shared state into a single logical unit. Fabric has no equivalent. Each package must be decomposed into individual stored procedures with shared state refactored into table-based or parameter-based patterns.
Cursor-based row-by-row processing, a common pattern in mature Oracle codebases, needs to be refactored into set-based operations for Fabric performance. Triggers, sequences, materialized views, and database links each require different Fabric-native replacement strategies. Oracle licensing pressure often creates artificial urgency, pushing teams to start migrating before the PL/SQL analysis is complete.
Typical timeline: 18 to 36 months manual, 7 to 12 months AI-accelerated.
SQL Server to Fabric
SQL Server to Fabric is the fastest migration path thanks to roughly 85% T-SQL compatibility. Basic stored procedures, views, and functions carry over with minimal changes. But the 85% compatibility covers the SQL language, not the ecosystem. SSIS packages with custom C#/VB.NET Script Tasks need complete replatforming. SQL Agent jobs need migration to Fabric Data Factory triggers. Windows Authentication must shift to Entra ID. CLR objects, linked servers, and cross-database queries are unsupported.
The T-SQL compatibility creates a dangerous planning assumption: that the migration is nearly done before it starts. Teams discover the ecosystem gap during full migration, when hundreds of SSIS packages, dozens of Agent jobs, and entrenched authentication patterns consume more effort than the T-SQL conversion itself. The 15% of unsupported T-SQL includes features (CLR, linked servers) that SQL Server teams use routinely.
Typical timeline: 8 to 18 months manual, 3 to 6 months AI-accelerated.

The AI-Accelerated Migration Framework
Regardless of source platform, every enterprise Fabric migration follows the same five-phase lifecycle. The difference between a 12-month manual migration and a 4-to-6-month AI-accelerated migration is not which phases you complete. It is how you complete them.
Phase 1: Discover (1-2 Weeks, Not Months)
Connect to the source platform and extract a complete estate inventory: every table, stored procedure, view, function, script, pipeline, job, and dependency. Manual discovery takes 3 to 12 weeks depending on estate size and typically misses objects that are undocumented or owned by engineers who have left. AI-accelerated discovery typically completes in 1 to 2 weeks, depending on estate access, metadata quality, and source complexity.
Phase 2: Assess (1-3 Weeks, Not Months)
Analyze every object for complexity, Fabric compatibility, conversion difficulty, and dependencies. Assign a complexity tier: standard (AI converts automatically), complex (engineer reviews AI output), or architect-required (human decision needed). Manual assessment relies on senior engineers reviewing objects one by one. AI-accelerated assessment scores the entire estate with Distinguished-level architect intelligence and typically completes in 1 to 3 weeks for most small-to-mid and mid-to-large estates.
Phase 3: Architect (2-4 Weeks, Not Months)
Design the target Fabric architecture: Warehouse vs. Lakehouse split, medallion layer design, domain segregation across workspaces, and dimensional model optimization. This phase requires the deepest expertise and is where most teams either wait months for a senior hire or proceed with insufficient guidance. AI-assisted architecture planning is grounded in the actual estate analysis, not generic best-practice templates, and typically takes 2 to 4 weeks, including review of target patterns, workspace design, data model decisions, and migration waves.
Phase 4: Convert (Months, Not Quarters)
Convert source code to Fabric-native patterns. This is the largest phase by effort volume, and the one where AI acceleration has the highest impact. Depending on source platform, 70 to 90% of objects convert automatically, with the remaining 10 to 30% routed to engineers with specific context on what needs human judgment. Manual conversion is linear: more objects means more months. AI-accelerated conversion runs in parallel and reduces the effort curve, but full conversion, remediation, code review, and deployment typically take 2 to 8 months depending on source platform and complexity.
Phase 5: Validate (Built-In, Not Bolted-On)
Generate automated validation scripts that compare source platform output against Fabric output at the data level. Row counts, aggregation results, edge-case behaviors, and business logic results are validated systematically. Manual testing is inconsistent and incomplete at enterprise scale. AI-generated validation suites cover the full scope of converted objects.
3XDE MigrateTo Fabric Accelerator
Learn how 3X Data Engineering's MigrateTo Fabric Accelerator handles all four source platforms (Synapse, Teradata, Oracle, and SQL Server) through a single AI-powered migration framework.
Explore the Accelerator: https://www.3xdataengineering.com/accelerators/migrate-to-fabric
How 3X Data Engineering Approaches Enterprise Fabric Migration

3X Data Engineering built the MigrateTo Fabric Accelerator as a single platform that handles all four source platforms: Synapse, Teradata, Oracle, and SQL Server. The accelerator is infused with Distinguished-level architect experience, the kind of cross-platform expertise that takes years to develop and is nearly impossible to hire at scale.
For each source platform, the accelerator connects directly, performs a comprehensive deep dive into the estate, runs AI-powered complexity scoring on every object, and produces a full migration blueprint: architecture recommendations, conversion artifacts, sprint plans, and validation test suites. The output is not a high-level assessment. It is production-ready artifacts that engineers review, validate, and deploy.
The assessment phase that takes 3 to 6 months manually compresses to 2 to 4 weeks. The full migration that takes 8 to 36 months (depending on source platform) compresses to 3 to 12 months, depending on source platform, estate size, validation scope, and deployment complexity. Engineers make every architecture decision and review every complex conversion. The accelerator handles the volume and brings Distinguished-level expertise to every object.
Get a Fact-Based Migration Roadmap in 1-2 Weeks
If your team is evaluating a migration to Microsoft Fabric from any source platform, 3X Data Engineering's Acceleration Advisory delivers a fact-based migration roadmap in 1 to 2 weeks, not months.
Talk to 3XDE Advisory: https://www.3xdataengineering.com/advisory
Looking Ahead
The migration to Microsoft Fabric is not a question of if. It is a question of how long, how much risk, and how much engineering effort. The answer depends entirely on where you are starting. Teams that plan for the source-specific challenges finish in months, not years. Teams that do not are still estimating.
