Synapse Dedicated SQL Pool to Microsoft Fabric: A Practical Migration Guide

Hariharan Arulmozhi, Founder & CEO, 3X Data Engineering
Microsoft Fabric is now the strategic direction for new analytics capabilities. Teams running production workloads on Synapse Dedicated SQL Pool need a migration plan grounded in source-system facts, not object-count estimates. This guide explains the issues that derail Synapse to Fabric migrations and a practical five-phase approach.

Key takeaways

  • Synapse Dedicated SQL Pool feature investment has stopped. Fabric Warehouse is the destination.
  • T-SQL compatibility is high but not complete. Distribution logic disappears. SSIS packages do not run in Fabric.
  • Most production deployments end up with a hybrid Warehouse plus Lakehouse architecture, not Warehouse alone.
  • Realistic execution timeline with accelerators: 12 to 18 weeks for mid-size estates. Manual programs commonly run 12 to 18 months.

The current state of Synapse Dedicated SQL Pool

Synapse Dedicated SQL Pool is in maintenance. Microsoft has not deprecated it, but feature investment moved to Fabric. New analytics capabilities ship in Fabric first and often only ship in Fabric. The practical reading: teams running Synapse Dedicated have a finite window to plan and execute a migration before they lose access to new capabilities and start paying for a platform on a one-way track.

The buyer question is not whether to migrate. It is how to migrate without a 12 to 24 month program.

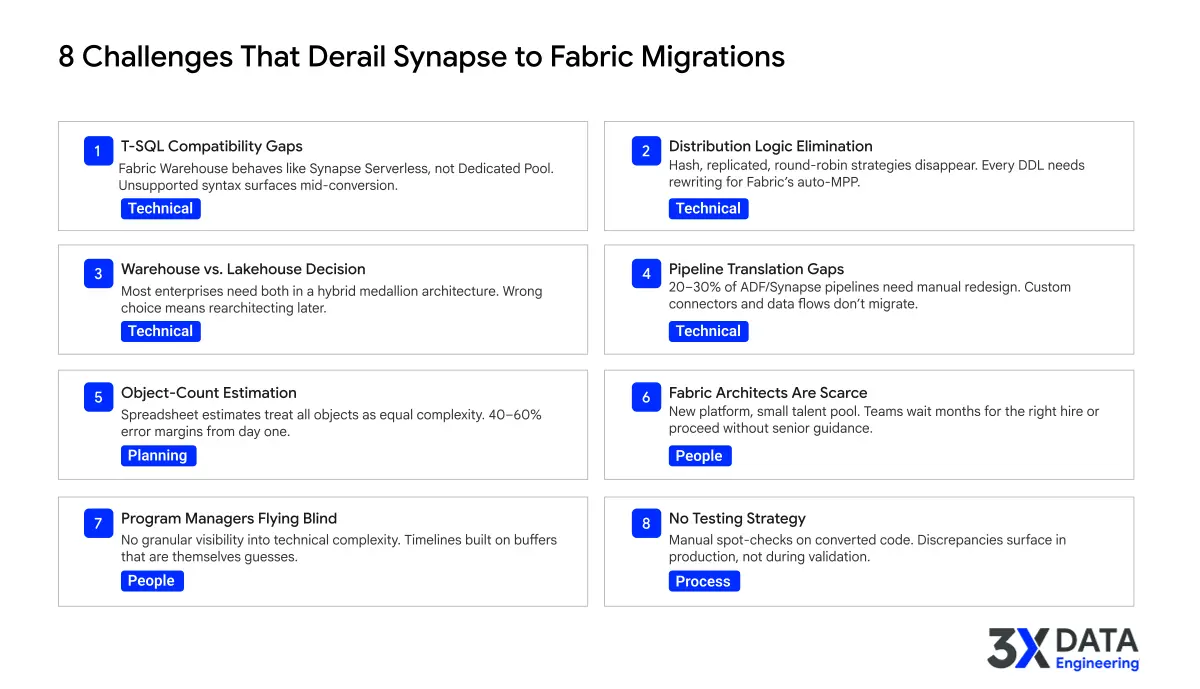

Six issues that derail Synapse to Fabric migrations

Migrations stall on the same six issues across most estates we see.

1. T-SQL compatibility gaps that only surface during conversion

Fabric Warehouse supports T-SQL but not the same T-SQL Synapse Dedicated runs. Multi-statement table-valued functions, certain proprietary syntax, and a handful of external table patterns are unsupported or require rearchitecting. Data type differences add another layer. Every stored procedure and view needs assessment, not assumption.

2. Distribution logic that no longer exists

Synapse Dedicated requires explicit table distribution: hash, replicated, or round-robin. Teams spent real effort choosing distribution keys and tuning around them. Fabric Warehouse handles distribution automatically through its MPP engine. Every CREATE TABLE with a distribution clause needs to be rewritten. More importantly, the performance assumptions baked into the source schema do not carry over.

3. The Warehouse versus Lakehouse architecture decision

Synapse Dedicated maps to one destination: Fabric Warehouse. But most production deployments use both Warehouse and Lakehouse in a hybrid medallion architecture. Lakehouse handles Bronze and Silver via Spark. Warehouse handles the Gold layer via T-SQL. Teams that migrate everything into Warehouse often rearchitect six months later when ingestion pipelines would have run better in Lakehouse.

4. Pipeline translation is partial

Azure Data Factory and Synapse Pipelines can migrate to Fabric Data Factory via Microsoft's migration assistant, but the assistant handles supported activities only. Custom connectors, complex expressions, and mapping data flows often need manual rework. Plan for 20 to 30 percent of pipelines requiring redesign in Fabric-native patterns.

5. Estimation built on object counts, not complexity

The single biggest cause of timeline overruns is estimation built on object count multiplied by an average conversion time. A 50-line standard stored procedure and a 500-line procedure with nested cursors are not the same conversion effort. Without object-level complexity scoring, the average bakes a 40 to 60 percent error margin into the plan from day one.

6. Senior Fabric architects are scarce

Fabric is still a relatively new platform. The pool of architects with hands-on experience designing enterprise-grade Fabric solutions and making Warehouse versus Lakehouse decisions under real constraints is small. Most enterprises cannot hire this expertise fast enough to meet migration timelines. The result is teams either proceed without senior guidance or wait months for a hire.

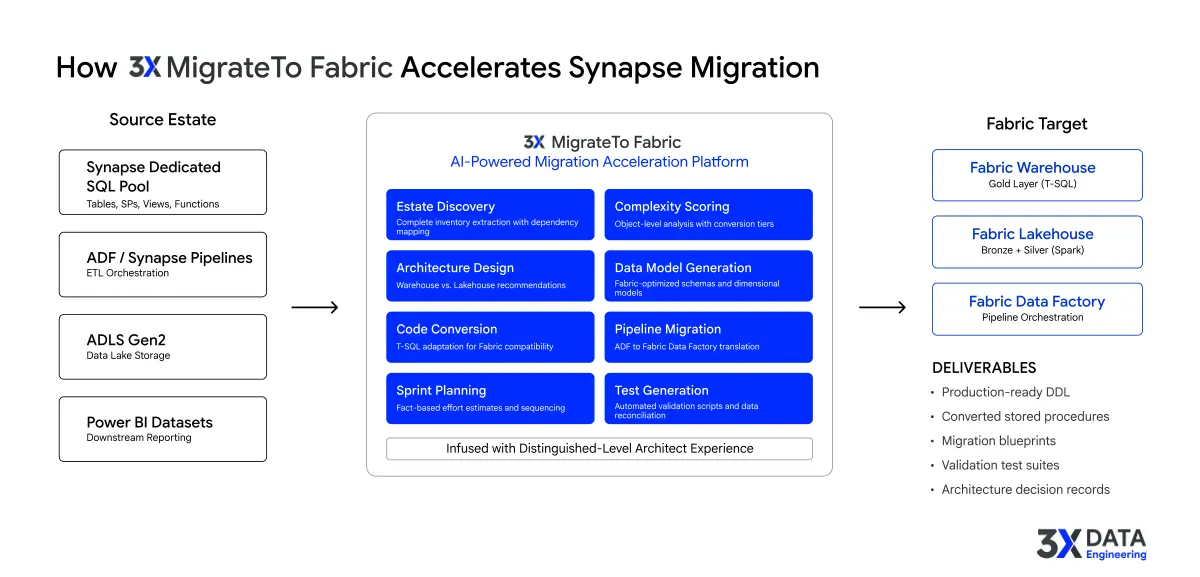

A five-phase migration approach

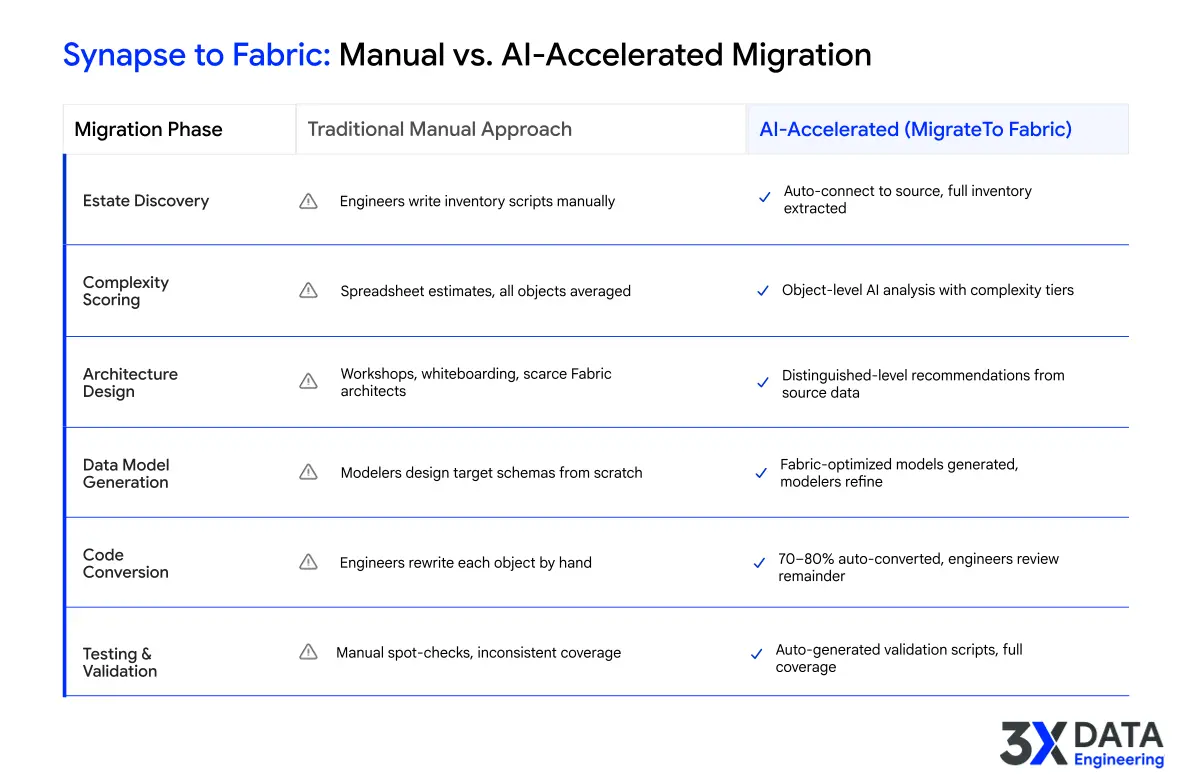

The Modernization Canvas approach replaces sequential manual work with five parallel phases.

  1. Discover. Source-connected estate inventory across tables, stored procedures, views, functions, indexes, and pipelines. Read-only access. No spreadsheet inventory.
  2. Assess. Object-level complexity scoring against T-SQL to Fabric compatibility. Dependency and lineage mapping. Risk identification on unsupported constructs.
  3. Architect. Target Fabric architecture decisions: Warehouse versus Lakehouse split, workspace segmentation, medallion layering. Reviewed by a senior architect.
  4. Convert. Bulk conversion of T-SQL stored procedures and views to Fabric-compatible patterns. Pipeline translation. Production-ready DDL and sample converted procedures.
  5. Validate. Automated reconciliation comparing source and target outputs. Output parity confirmed before cutover on every wave.

Plan your modernization with a fact-based blueprint

If you are working on a Synapse to Fabric migration, the next practical step is a fixed-price Modernization Assessment. Source-connected discovery, complexity scoring, target architecture, effort estimation, and bulk-converted sample code, delivered as a Modernization Canvas in 8 business days. No long discovery, no procurement cycle, Director-level signing authority.

Frequently Asked Questions

Answering common questions about 3X Data Engineering to help you get started on your modernization journey.

Not entirely. External tables, multi-statement TVFs, and certain proprietary syntax are unsupported. Data type differences also apply. Every object needs assessment.
Most production deployments use both in a hybrid medallion architecture. Lakehouse for Bronze and Silver via Spark. Warehouse for the Gold layer via T-SQL.
They are removed entirely. Fabric handles distribution automatically through its MPP engine, so every DDL with hash, replicated, or round-robin needs rewriting.
Microsoft's migration assistant handles supported activities. Plan for 20 to 30 percent of pipelines requiring manual rework for custom connectors and complex expressions.
Mid-size estates take 10 to 14 weeks with accelerators against a 6 to 12 month manual baseline. Large estates run 14 to 20 weeks. The timeline depends on source-connected access and accelerator deployment from week one.
